Approximately 14.8 miles of 96-inch diameter pipeline.

SWSP Segment B

B1 – Brittmoore Road to White Oak Bayou

  • Pipeline Diameter: 96″
  • 5.8 Miles long

Anticipated Construction Program Schedule

DESIGN

Ended – Spring 2021

BID

Winter 2022

CONSTRUCTION

Summer 2022 – Spring 2025

Design Consultant: Black & Veatch

Contractor: Harper Brothers Construction

PDF Map: SWSP – Segment B1

Contractor Notice to Proceed: April 2022

Project Completion: Spring 2025

Dates are subject to change

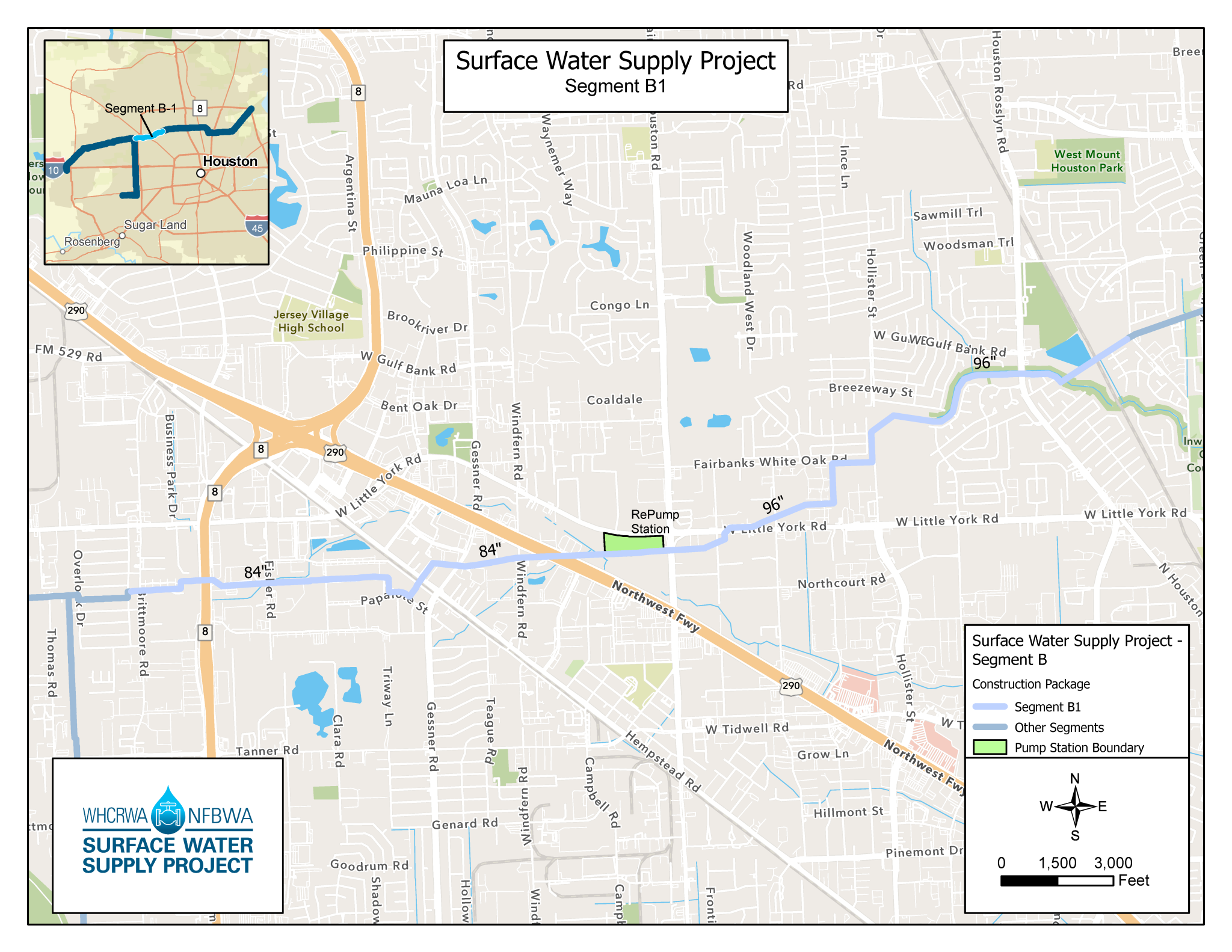

SWSP - Segment B1

B2 – White Oak Bayou to IH-45W

  • Pipeline Diameter: 96″
  • 4.6 Miles long

Anticipated Construction Program Schedule

DESIGN

Ended – Spring 2021

BID

Winter 2022

CONSTRUCTION

Summer 2022 – Spring 2025

Design Consultant: Black & Veatch

Contractor: Harper Brothers Construction

PDF Map: SWSP – Segment B2

Contractor Notice to Proceed: April 2022

Project Completion: Spring 2025

Dates are subject to change

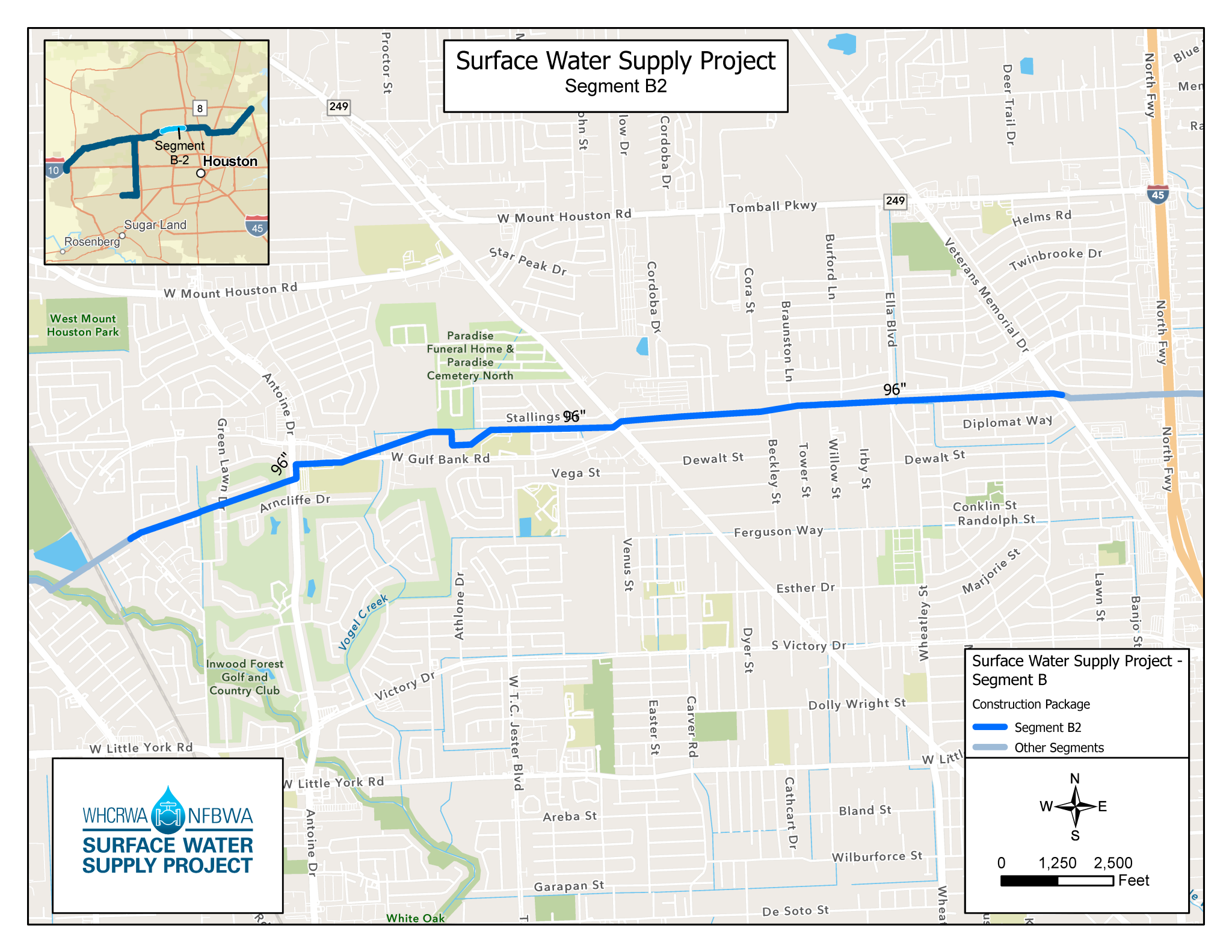

SWSP - Segment B2

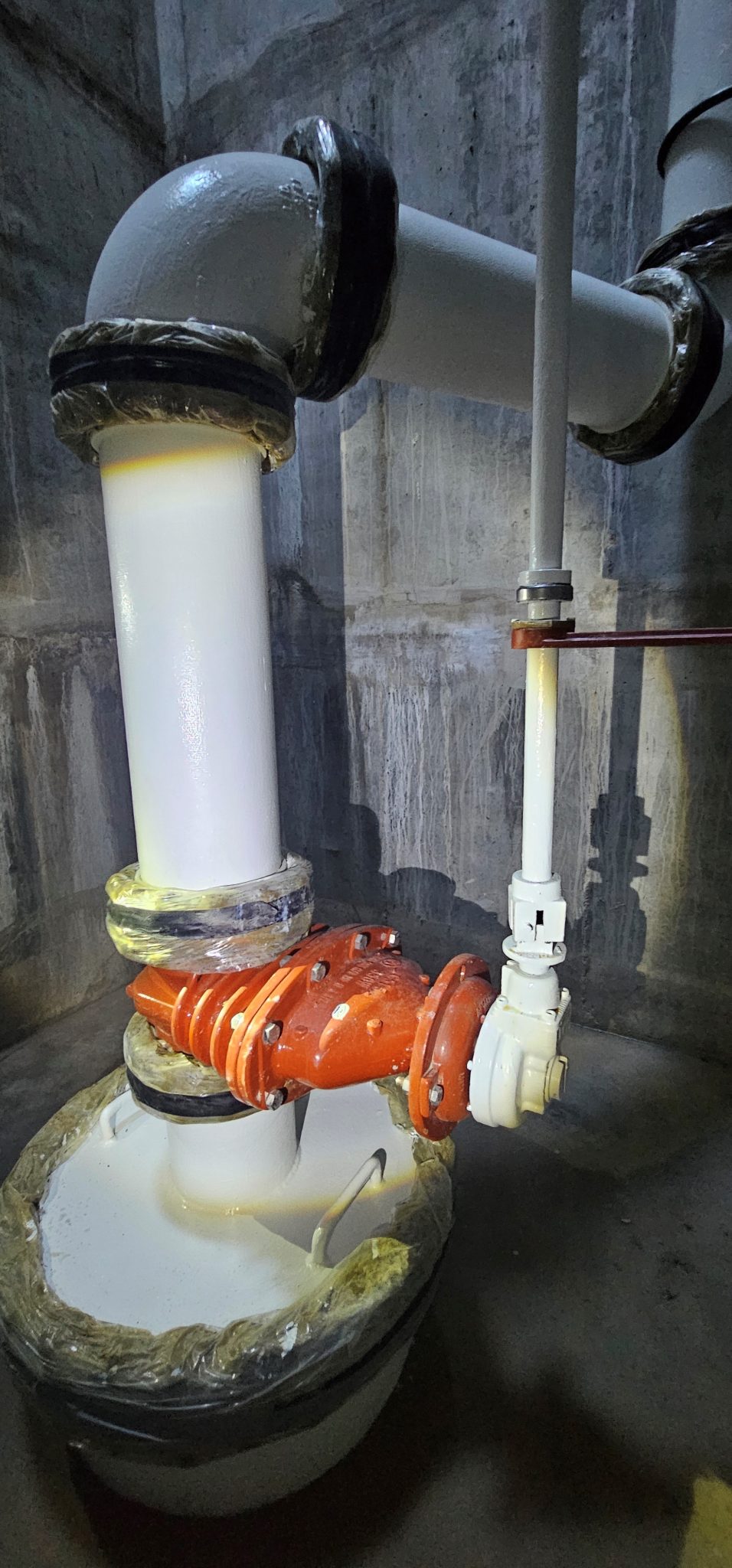

B3 – West of IH-45 to Hopper Road (Long Tunnel)

  • Pipeline Diameter: 96″
  • 4.4 Miles long

Anticipated Construction Program Schedule

DESIGN

Ended Spring 2021

BID

Winter 2022

CONSTRUCTION

Spring 2025

Design Consultant: Black & Veatch

Contractor: Jay Dee Contractors, Inc.

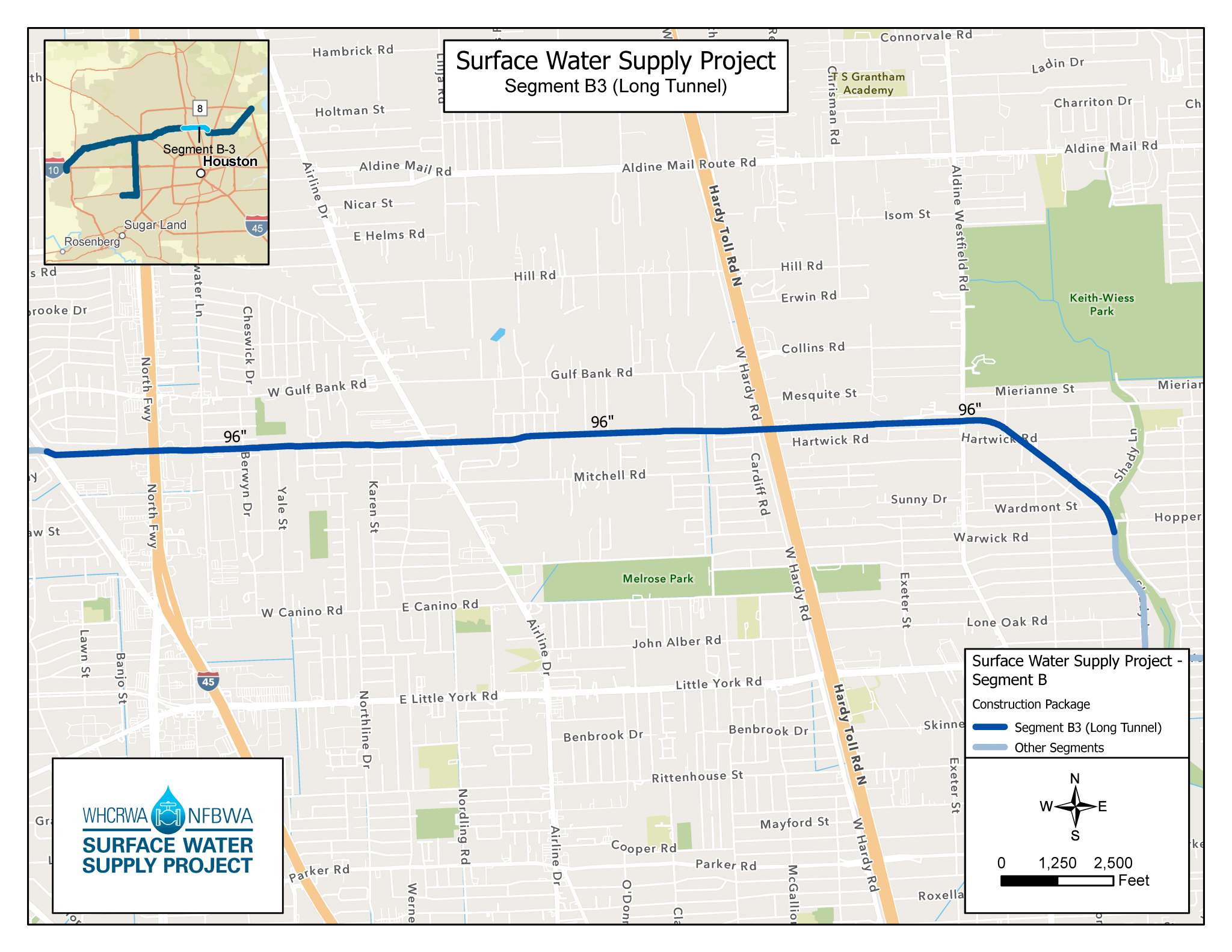

PDF Map: SWSP – Segment B3

Contractor Notice to Proceed: May 2022

Project Completion: Summer 2025

Dates are subject to change

SWSP - Segment B3
